How Much Does a School Playground Cost in Australia?

See realistic installed package ranges, what each budget includes and the school-specific costs that move the final price.

Moduplay Team 13 min read September 22, 2026 Playground Design & Planning Resources
School playground with colourful equipment and playground surfacing

Play equipment that is suitable for school use can start from a few thousand dollars, but in practice, a complete school playground that is installed, with compliant under-surfacing can cost around $50,000 for a compact installed package, $80,000 to $165,000 for a larger primary school project, or more than $200,000 for a major multi-zone playground.

Those figures are useful, but they only make sense when you know what is included.

A school can spend the same total budget in many different ways. One project may put most of the money into equipment and use organic playground surfacing. Another may choose less equipment and spend far more on synthetic playground surfacing, accessible paths or difficult site works.

School playgrounds also work hard. Hundreds of students can arrive at once during recess and lunch. The design needs enough activities, clear entry and exit points, age-appropriate challenge, good teacher sightlines and materials that can handle heavy daily use.

The examples below include supply and delivery, installation and the stated surfacing allowance. They do not automatically include shade, fencing, seating, landscaping, demolition, drainage, edging or difficult site preparation.

All figures are in Australian dollars, exclude GST and are indicative. Prices and ranges were last reviewed in August 2026. Your final price will depend on product selection, location, access, ground conditions and project scope.

The quick answer

Indicative installed package

$50,000 to $60,000 plus GST

Indicative installed package

$80,000 to $100,000 plus GST

Indicative installed package

$130,000 to $165,000 plus GST

Indicative installed package

$200,000+ plus GST

On this page

These are installed package ranges like the examples below. They are not necessarily complete schoolyard prices.

First, decide what your budget needs to cover

Equipment price: Playground structures and freestanding play items. It excludes freight, installation and surfacing unless the quote says otherwise.

Installed playground package: Equipment, delivery, installation and the nominated surfacing. The examples in this guide use this type of budget.

Complete schoolyard project: The installed playground plus demolition, drainage, concrete, edging, shade, fencing, accessible paths, seating, gardens and other schoolyard work included in the agreed scope.

For early planning, allow about half of the total project budget for playground equipment. Equipment may take a larger share on a flat site with loose-fill (particulate) materials. It may take a smaller share when the project includes tiles or unitary surfaces, difficult earthworks, drainage, shade, fencing, paths or landscaping.

This is a starting point, not a quoting formula.

Moduplay’s live pricing shows standard product pricing separately. Freight, installation and project work still need a site-specific quote.

6 decisions to make before requesting designs

01

Who Will Use It?

A Foundation to Year 2 zone needs a different scale and type of challenge from a Years 3 to 6 or secondary space.

02

How Many Students Need to Use It at Once?

Capacity matters as much as the number of products during short break periods.

03

Can Staff Supervise It Clearly?

Sightlines, entry points and connected zones should be part of the brief.

04

What Is the School’s Inclusion Goal?

Plan physical access, sensory choice, social play and quiet areas from the start.

05

What Must the Budget Cover?

Confirm whether the approved figure is for equipment, an installed package or the complete schoolyard upgrade.

06

Can the Project Be Staged?

Plan the final layout, drainage, paths, fall zones and future connections before stage one is built.

These are installed package examples. They use the approved Moduplay concept allowances and assume a flat, workable site with ideal access and ground conditions.

$58,000 (+/-)

plus GST

Compact Installed Package

Compact school playground concept with climbing, sliding and imaginative play elements

This is a practical entry point for a smaller junior-primary zone, a targeted replacement or a school with a limited footprint.

Cost breakdown

Equipment: 52% of total

$30,000


Installation: 14% of total

$8,000


Surfacing: 34% of total

$20,000

Indicative total

$58,000

What this budget can usually deliver

  • A compact multi-play structure with climbing, sliding and social or imaginative play.
  • A design that concentrates play value into a controlled footprint.
  • Playground surfacing across the nominated impact area.

What to watch

  • Shade, perimeter fencing, seating, landscaping and major site works are separate.
  • The site needs to be flat, accessible and straightforward for the budget to hold.

$87,000 (+/-)

plus GST

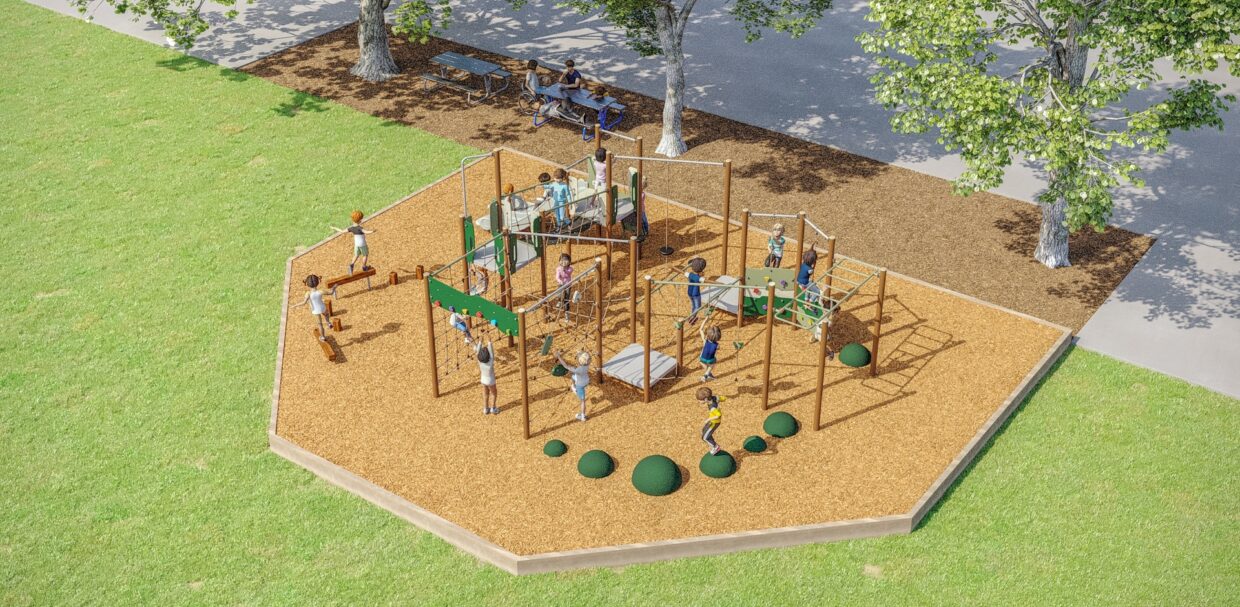

More Equipment with Loose-Fill Surfacing

Mid-sized school playground concept using recycled panels and loose-fill playground surfacing

This example directs most of the budget into the play equipment. The lower surfacing allowance makes room for a larger, more adventurous play offer.

Cost breakdown

Equipment: 72% of total

$63,000


Installation: 18% of total

$16,000


Surfacing: 9% of total

$8,000

Indicative total

$87,000

What this budget can usually deliver

  • More climbing, movement and interactive play.
  • More concurrent play opportunities for a bigger student group.
  • Loose-fill materials to keep the initial surfacing cost down.

What to watch

  • Loose-fill surfacing needs regular raking, depth checks and top-ups.
  • Firm accessible paths or selected continuous-surface areas may need a separate allowance.

$95,000 (+/-)

plus GST

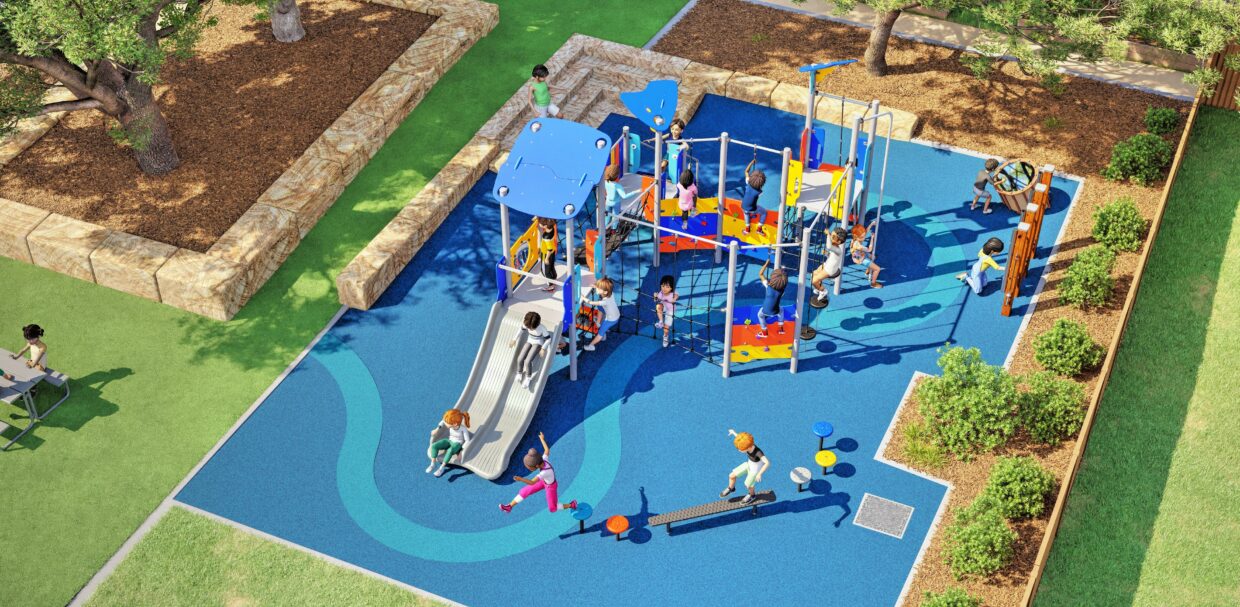

Balanced Equipment and Unitary Surfaces

School playground concept with themed colours, climbing play and mixed playground surfacing

This budget balances the equipment scope with a more substantial surfacing package. It suits schools that want a distinct design, multiple activity types and a firmer finished area.

Cost breakdown

Equipment: 58% of total

$55,000


Installation: 16% of total

$15,000


Surfacing: 26% of total

$25,000

Indicative total

$95,000

What this budget can usually deliver

  • A strong central structure with climbing, sliding and social play.
  • More room for school colours, themed details or selected inclusive elements.
  • A combination of unitary and loose surfacing.

What to watch

  • A fully accessible route through the whole space may require more continuous surfacing.
  • Shade and wider landscape work remain separate unless listed in the quote.

Related School Project

Rainbow Street Primary School playground

Rainbow Street Primary School

Randwick, NSW

Published Equipment Budget: $70,000 to $80,000

Delivered end-to-end by Moduplay, the new playspace at Rainbow Street Primary School turns a previously underutilised corner of the grounds into a fresh, purpose-built play zone. Notes of blue echo the school uniform, giving the space its own unmistakable identity. Already well-used and well-loved, it’s the perfect finishing touch to the school’s play offering.

$144,000 (+/-)

plus GST

Large Playground with Substantial Unitary Surfaces

Large school playground concept with extensive climbing, sliding and playground surfacing

This is a larger school project with enough budget for a strong equipment package and a sizeable continuous surfacing area.

Cost breakdown

Equipment: 52% of total

$75,000


Installation: 15% of total

$22,000


Surfacing: 33% of total

$47,000

Indicative total

$144,000

What this budget can usually deliver

  • A large central structure or several connected activity zones.
  • More challenge for upper-primary students and more options for concurrent use.
  • A firmer surface that can improve circulation and day-to-day maintenance.

What to watch

  • Bigger does not automatically mean better. The project still needs a clear age and capacity brief.
  • Drainage and levels must be right before a unitary surface system is installed.
  • Ancillary items can push the complete schoolyard cost well beyond this package figure.

Related School Project

Mueller College playground

Mueller College

Rothwell, QLD

Published Equipment Budget: $100,000 to $120,000

Nestled on the Northside of Brisbane, Mueller College is now home to not one, but TWO new Moduplay play areas for their Primary & Prep areas.

$161,000 (+/-)

plus GST

Surfacing-Led Large Playground

Large school playground concept with outdoor learning, balance play and extensive playground surfacing

This example shows how strongly surfacing can shape the total. The surfacing allowance is almost as large as the equipment allowance.

Cost breakdown

Equipment: 43% of total

$70,000


Installation: 17% of total

$27,000


Surfacing: 40% of total

$64,000

Indicative total

$161,000

What this budget can usually deliver

  • Active climbing, balance, sensory or outdoor-learning elements.
  • Substantial playground surfacing with stronger circulation between activities.
  • A more finished result on an ideal, prepared site.

What to watch

  • The allowance does not include every concrete path, edge, garden or shade structure.
  • Complex levels, drainage or demolition can still add significant cost.

Related School Project

Koo Wee Rup Primary School playground

Koo Wee Rup Primary School

Koo Wee Rup, VIC

Published Equipment Budget: $94,000 to $98,000

Koo Wee Rup Primary School’s brand new recreation space was designed to give every student a genuine way to join in. Completed in May 2025, the project combines an inclusive playground, challenging climbing equipment and a learn-to-ride circuit, creating opportunities for children of different ages, abilities and play preferences to have fun together.

$204,000 (+/-)

plus GST

Major School Playground

Major school playground concept with large structures, multiple play routes and playground surfacing

At this level, a school can create a major playground with a large equipment package, higher capacity and several types of play.

Cost breakdown

Equipment: 60% of total

$123,000


Installation: 11% of total

$22,000


Surfacing: 29% of total

$59,000

Indicative total

$204,000

What this budget can usually deliver

  • A large structure, multiple activity routes or separate zones for different users.
  • More height, challenge, sensory choice and scope for custom design.
  • Enough capacity to serve a large school population when the layout is planned properly.

What to watch

  • A $200,000 installed package is not an unlimited complete schoolyard budget.
  • Major shade, civil works, retaining, fencing or outdoor classrooms can sit outside this figure.
  • Larger structures may need extra engineering, approval and installation coordination.

Related School Project – Coming Soon

Coming Soon: North Sydney School Project

North Sydney, NSW

A custom Connect Tower with rope bridges linking multiple towers, plus a junior play area beneath. The layout has been designed around a compact footprint within a unique and complex existing site.

Why school playgrounds cost more

School playground budgets need to handle peak use, varied age groups and school-site constraints. These six factors usually shape the final scope.

01

Student Capacity at Recess and Lunch

School playgrounds have short, intense periods of use. A design needs enough activities that students can use at the same time. Look for multiple entry and exit points, parallel climbing routes, open rope play and activities that do not depend on one child finishing before the next can start.

02

Age Zoning and Challenge

Foundation to Year 2 students generally need lower-scale equipment, simple movement, sensory play, role play and clear supervision. Years 3 to 6 usually need more climbing, upper-body challenge, balance, speed and choice. Separate or overlapping zones usually work better than forcing one compact structure to suit everyone.

03

Site Access, Demolition and Existing Conditions

School sites can be harder to build in than open parks. Delivery routes may pass through gates, car parks, covered walkways or active learning areas. Removing old equipment, concrete, edging or unsuitable fill can add cost before the new playground starts. Rock, roots, poor drainage and underground services can also change footing and excavation costs.

04

Surfacing and Accessibility

A larger fall zone means more surfacing, even when the equipment price stays the same. Loose-fill (particulate) materials are usually cheaper upfront. Tiles and unitary surfaces cost more but can create a firm surface, support clearer routes and reduce daily displacement. Inclusive design also needs firm routes, sensory choice, social play and activities at different heights and challenge levels.

05

Shade, Fencing and Schoolyard Infrastructure

Shade, perimeter fencing, gates, accessible paths, seats, outdoor classrooms, drinking fountains and landscaping can materially change the final cost. Decide whether this is a playground replacement or a broader schoolyard upgrade. They are different scopes.

06

Timing, Compliance and Handover

Holiday installation can reduce disruption, but it creates a fixed construction window. Allow time for design approval, procurement, manufacturing, service locating, site preparation, installation, surfacing, inspection and handover. Confirm who provides the inspection, surfacing documentation, maintenance manuals, as-built information and warranty records.

A plain-English guide to school playground surfacing

Where equipment has a free height of fall, the layout may require impact-attenuating surfacing. The 3 working categories are loose-fill (particulate) materials, tiles and unitary surfaces. Final product mapping and technical requirements must be confirmed for the selected equipment and project specification.

Loose-Fill

Loose-fill playground surfacing with wood chip

(Particulate) materials – wood chip or sand

Lower upfront cost
Higher maintenance

Need raking, depth checks, top-ups and clear edging. They are less suitable as the only route for wheeled mobility.

Tiles

Impact-attenuating playground surface tiles

Rubber impact-attenuating tiles manufactured before installation

Higher upfront cost
Lower maintenance

Need a prepared base and site-specific installation details. Product build-up and permitted claims must be confirmed before use.

Unitary Surfaces

Unitary playground surfacing with wetpour

Wetpour and complete multi-layer systems where technically accurate

High upfront cost
Lowest maintenance

Can support firm access, patterns and shapes. Cost changes with area, fall height, colours and base preparation.

A project can combine categories to target firm access, impact areas and high-wear zones without using the same surface everywhere.

What should a school playground quote show?

  • Equipment supply price.
  • Packaging, delivery, unloading and access requirements.
  • Installation, travel and accommodation where relevant.
  • Underground service locating, temporary fencing and site security.
  • Skip bins, spoil removal and tipping fees.
  • Footings, slabs, roadbase and other concrete work.
  • Playground surfacing type, area, depth and sub-base.
  • Edging, paths, drainage and retaining.
  • Shade, fencing, seating and landscaping.
  • Engineering, inspection and compliance documents.
  • Lead time, installation window and wet-weather allowances.
  • Maintenance manuals, warranties and spare-parts support.

Can a school stage the project?

Yes. Plan the final layout first so future fall zones, paths, drainage and equipment connections are protected. Start with the age group or capacity problem creating the most pressure. Make every stage safe and useful on its own, and avoid temporary surfacing or edges that need to be removed later.

Funding a school playground

Funding commonly comes from school capital budgets, P&C or P&F fundraising, community sponsorship and grants.

Do not start fundraising with a product list. Start with a clear scope, a target total, a contingency and a staged fallback plan. Grant programs and eligibility change, so check the live source at the time rather than relying on an old list in an article.

These completed projects show how different schools handled capacity, access, landscape conditions and the wider play brief. Their final costs are not published in this article.

Rainbow Street Primary School playground

Rainbow Street Primary School

Randwick, NSW

Inclusive layout with ramps, rubber surfacing and varied play from Kindergarten to Year 6.

Koo Wee Rup Primary School

Koo Wee Rup, VIC

Designed for peak use, with 28 activities and capacity for around 50 to 60 children.

Koo Wee Rup Primary School playground
Linuwel Steiner School playground

Linuwel Steiner School

East Maitland, NSW

Uses a mix of play types to create a nature-aligned playspace.

New Farm State School

New Farm, QLD

Shows how slopes, landscape treatment and teacher sightlines can be handled.

New Farm State School playground
Athelstane Primary School playground

Athelstane Primary School

Arncliffe, NSW

Uses mixed surfacing and the natural fall of the site to control cost and add play value.

Birchgrove Public School

Birchgrove, NSW

A broader schoolyard concept with play, sensory spaces, sport and outdoor-learning areas.

Birchgrove Public School playground

What is the cheapest realistic school playground budget?

A compact installed package can sit around $50,000 to $60,000 plus GST on an ideal site. A lower figure may be possible for a small equipment-only purchase, but delivery, installation and compliant surfacing still need to be allowed for.

Why does one $90,000 playground have more equipment than another?

Surfacing and site work can absorb a large share of the total. A project using loose-fill materials may direct more money into equipment. A project using tiles or unitary surfaces may reduce the equipment allowance but improve circulation and the finished space.

Can residential playground equipment be used at a school?

No. School equipment must be commercial-grade and suitable for heavy, multi-user use. Residential products are not designed for school duty cycles or commercial playground requirements.

How many students should the playground hold?

There is no universal number. Start with enrolment, the students using that zone, break-time patterns and what else is available in the yard. Ask the designer to state expected concurrent use and explain how students enter, move through and leave the equipment.

Can an inclusive playground use wood chip?

It can include wood chip, but loose-fill surfacing should not be the only route to every activity. Firm accessible paths and selected unitary-surface zones can make the overall space more usable.

Can we reuse our existing playground or playground surfacing?

Sometimes. Existing equipment and surfacing need to be assessed for condition, compliance, fall-zone compatibility, remaining life and whether parts are available. Reuse should be confirmed before it is relied on in the budget.

Can the playground be installed during school holidays?

Yes, and many schools prefer that. The full program still needs enough time for site work, concrete curing, playground surfacing, inspection and weather delays. Book early if a fixed holiday window matters.

How long does the project take?

The full timeline depends on design approval, product selection, manufacturing, site preparation and installation. Standard products generally move faster than bespoke structures. Ask for a project program, not just a delivery estimate.

Should we spend more on equipment or playground surfacing?

There is no fixed answer. Equipment drives play value and capacity. Playground surfacing drives safety, access, maintenance and the finished experience. The right split depends on the school brief and site.

What should we send for a first budget?

Send the school address, site photos, dimensions, preferred installation timing, age groups, target capacity, must-have activities and whether the budget must cover equipment only or the complete project.

Start with the school problem, then set the budget

A useful school playground budget starts with the problem you are trying to solve. Are younger students short on activities? Are Years 3 to 6 bored? Is the current area inaccessible? Is supervision difficult? Is the equipment worn out?

Once the need is clear, you can split the budget between equipment, installation, surfacing and schoolyard work without guessing.

Send Moduplay your site, target budget, year levels, capacity and must-haves. The team can tell you what is realistic, what is likely to move the cost and where the school can save without weakening the result.

PlayFigurator playground planning view and rendered playground concept

ONLINE PLAYGROUND PLANNING

Shape a Better Playground Brief

Bring students and stakeholders into the early planning conversation. PlayFigurator lets your school test site ideas, explore real Moduplay equipment, compare surfacing directions and shape a clearer playspace brief before detailed design begins.

  • Plan your site and test ideas early.
  • Explore playground equipment and surfacing.
  • Create a clearer brief with indicative pricing.

Get design inspiration, business tips and new product alerts straight to your inbox with our Moduplay Newsletter, the Playground Press once a month.


Back to top
